Project Background

This newly developed R40m Industrial site comprising of 3 platforms. The upper platform adjacent to the site’s entrance designated as Sectional 01. Has approximately 7000m2 of leveled ground and 1000m2 of cut bank.

Earlier Civils works of making hard engineered surfaces and the removal of vegetation changed the geotechnical properties of a soil. Resulting effect was on hydraulic conductivity meaning low seepage capacity and high surface runoff during high storm.

The surface run- off problem also attributed to the site’s geological composition. Ground on the southern side which constitutes 60% of this Section’s land size is mainly shale bedrock interbedded in layers.

For a newly developed site plans for Industrial Building Structures in the process of approved. Storm water runoff on Section 01 had not been an item of big concern up until Building Works on the lower section designated as Section 02 were underway. Flooding, debris accumulation presented serious concerns on Section 01.

Solution.

After several discussions between Developers and Dson Industries. Construction of a temporary storm channel was approved. One of goal of the goal was to establish a range of input parameters to implement a greater design standard.

Design Parameters.

  • Rainfall intensity
  • Protection of property
  • Storms of short duration and high intensity (similar to the 10 Cotober 2017 Durban Floods )
  •  To avoid flooding in the channels the minimum velocity of the flow to be 1.5 m/s.

Channel Specification

  • 450mm channel 5000 mm of the bank edge along the length of the bank.
  • Falling 0.8% from the centre line to one side into the existing V drain and 0.8% on the other side into a temporary manhole, to act as a silt trap.
  • The ground to the opposite side of the bank be cut to a fall from 5000mm to the channel at a slope of 1:10.
  • top of the bank to be cut level for 2000 mm and then fall 1:10 toward the channel for 3000 mm.
  • cut along the length of the channel to accommodate the fall of +- 500mm.

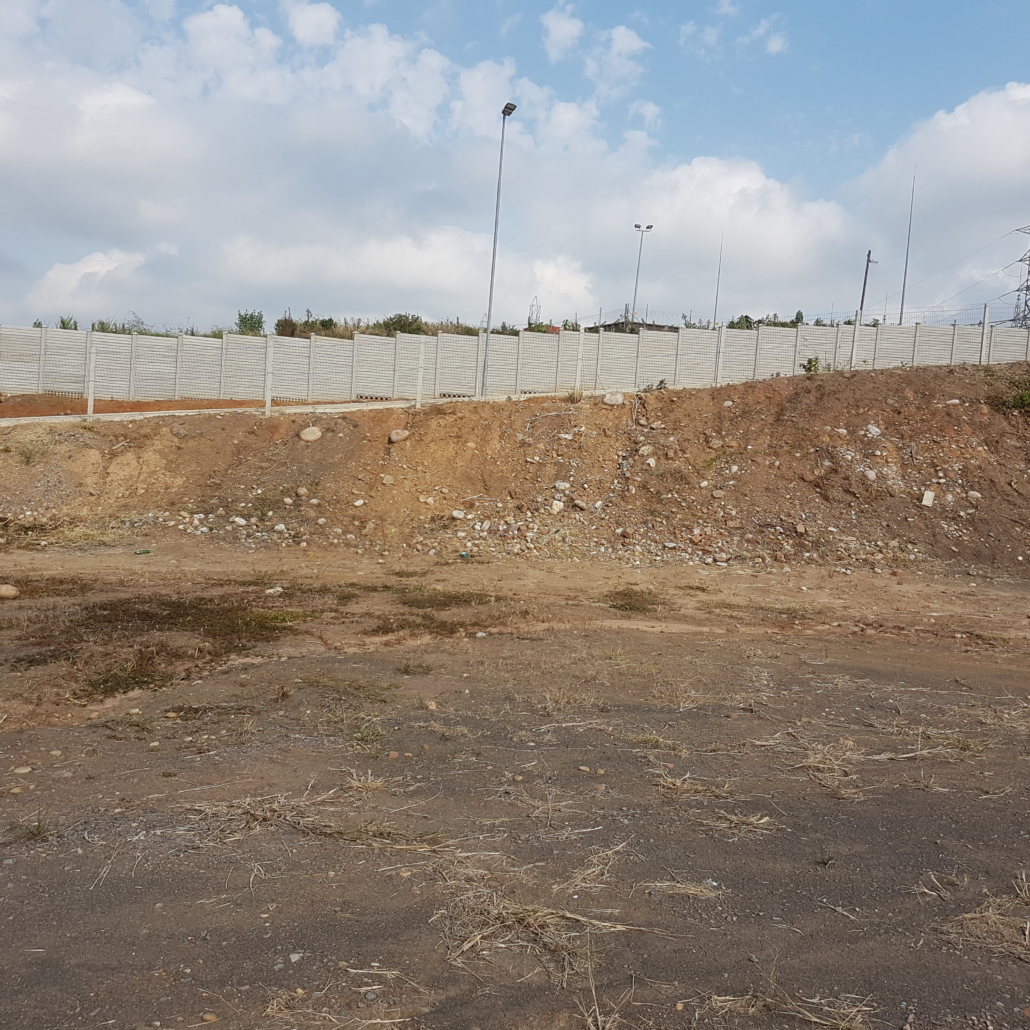

Challenges

In the course of the Preliminary works , day 2 after commencement of earth works. A big storm occurred by the time time it receded , trenches that had been dug all got flooded. To carry on with works , we had to pump all the water water scoop the muddy out.  The whole operation presented real life construction challenges and extra costs.

PROJECT BUILD COMPONENTS, SUPPLIED BY ENVIROMESH

  • Welded steel wire mesh gabion baskets
  •  Dedicated and experienced team for Storm Water Reticulations
  •  8 ton JCB TLB
  • 3 ton Bobcat S130
  • Double Drum Vibratory Roller
  • Plate Compactor
  • 1000ι Water Bowser
  • 450mm Half Round Precast Channel
  • Bricks for Silt Retention Chambers
  • 310mm UPVC heavy duty storm water chambers.

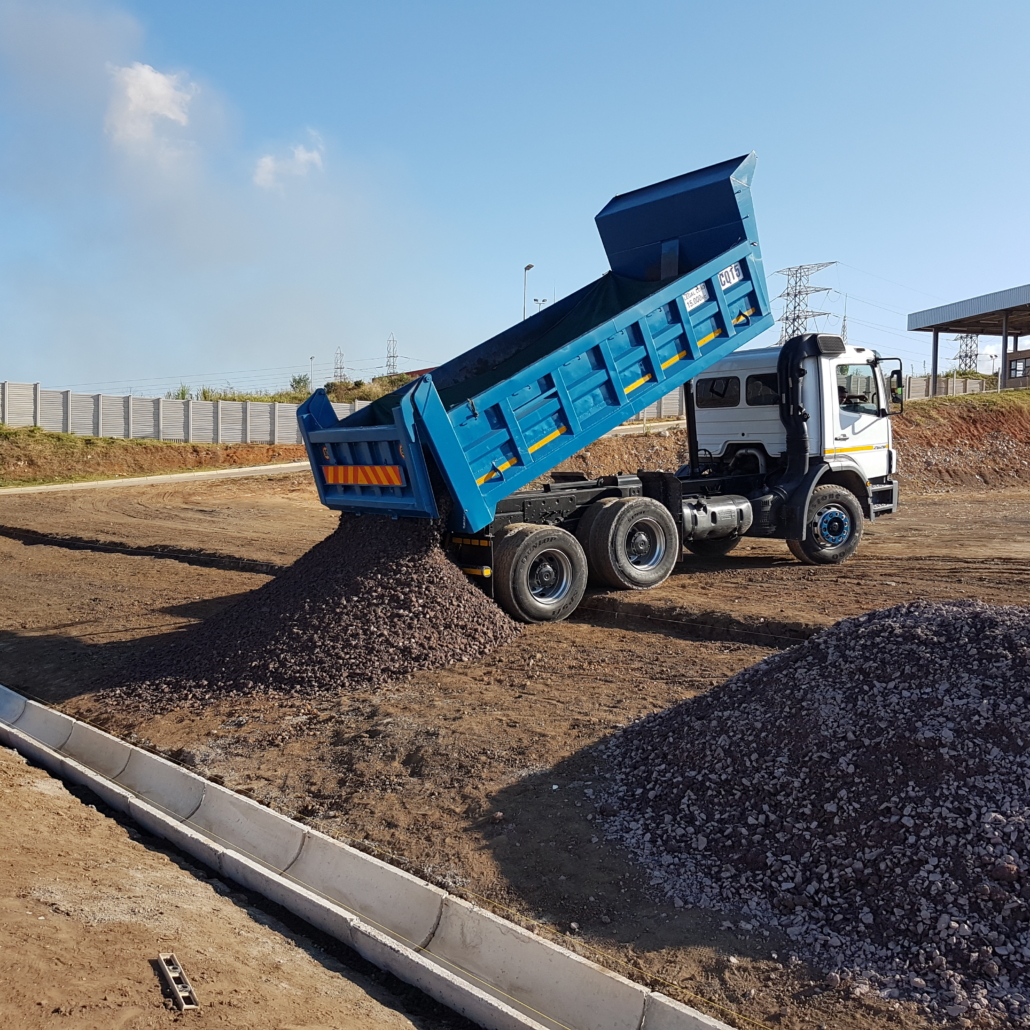

  • G7 Crusher Run
  • Full Kit Ross f7642 dls1 dumpy level
  • Insitu Rocks.

Services Provided By Dson  Industries.

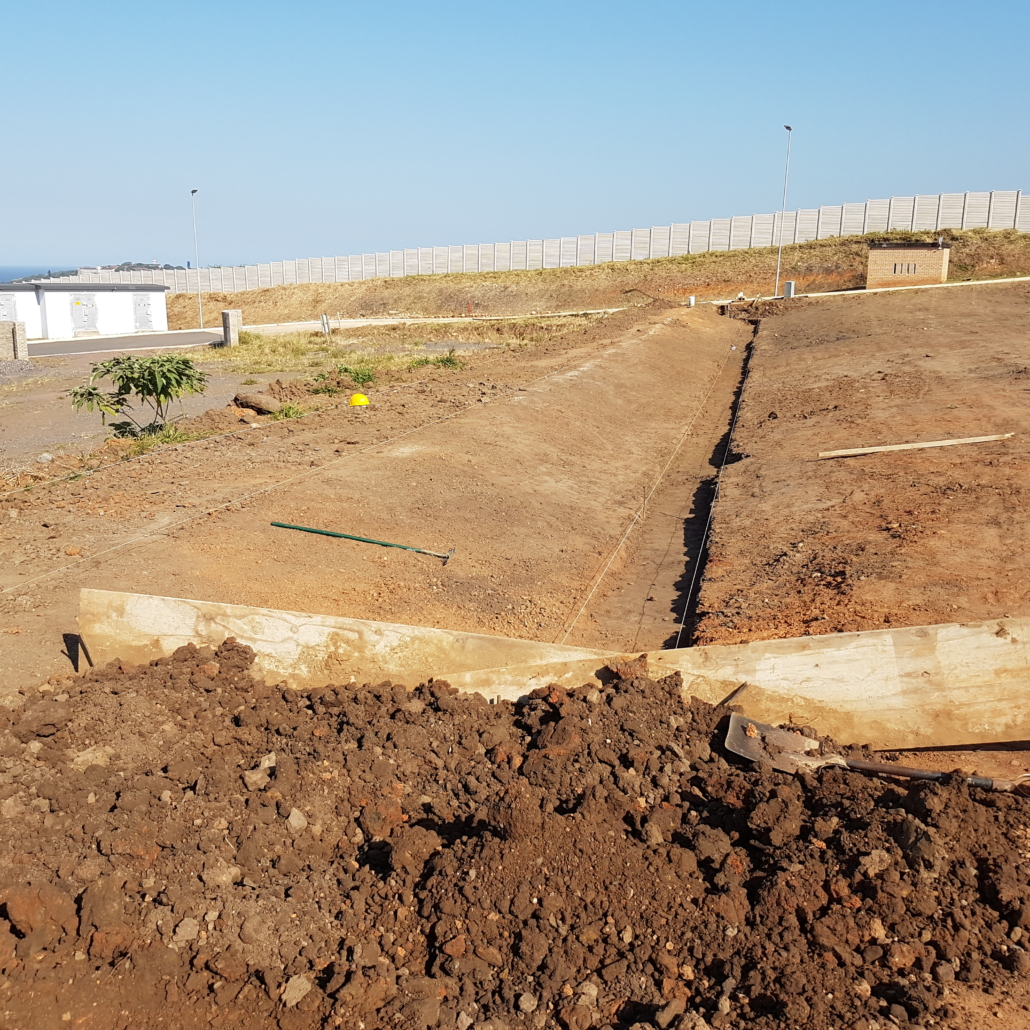

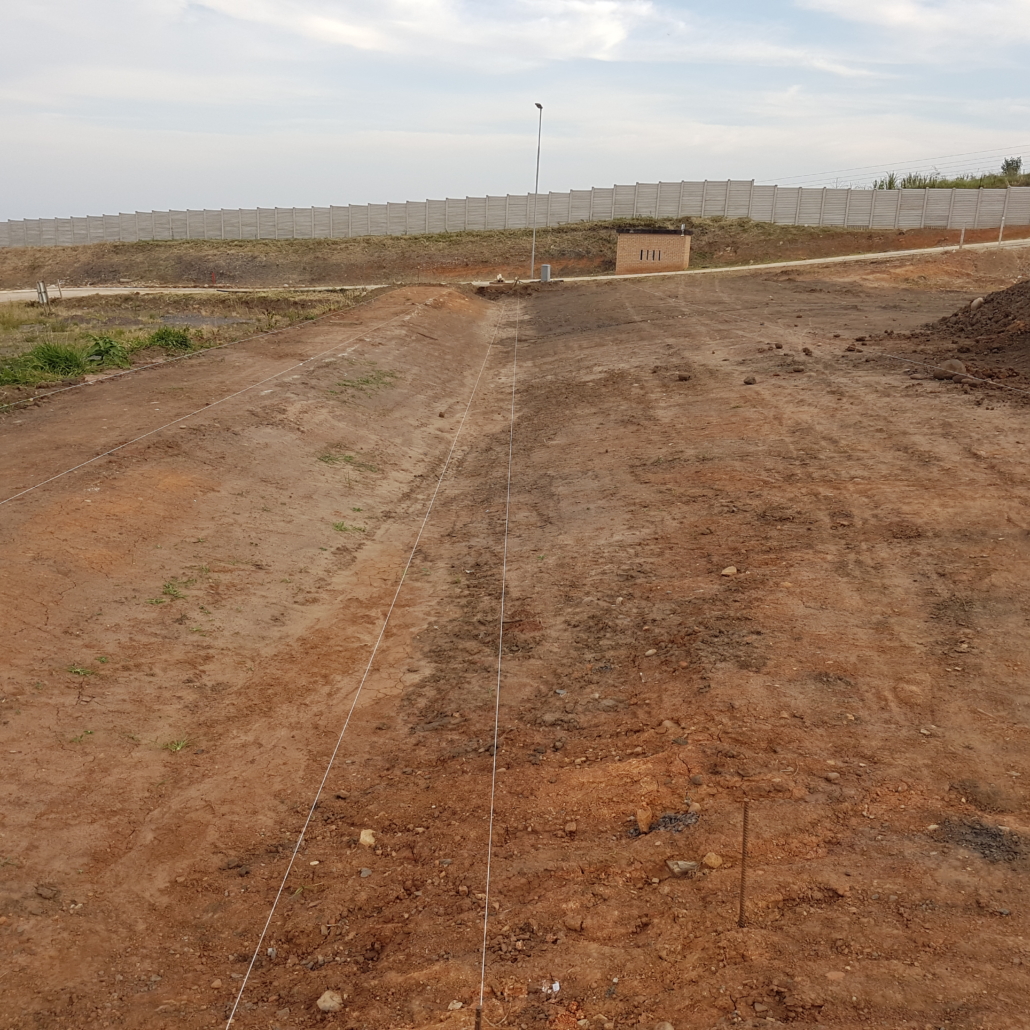

  • Site Survey Staking
  • Site Marking
  • Earth Works.
  • Silt Retention Chambers
  • Wingwalls.
  • Installation of 450mm Precast Concrete Channels.
  • Installation of the heavy 310mm heavy duty UPVC storm water pipes.
  • Application of Stabilising Materials
  • Installation of Slope Revetment

Dson Industries 2020
